Innovative flat-pack design bridge installed in Tweed Shire

Latest News

How can we keep paying for incompetence

The only way forward is going backwards. That’s how I explain the current situation of Byron Shire Council. The...

Other News

Byron’s Philo Café

Byron’s long-running discussion group – Byron Philo Café – is inviting members of the general public to join them on Friday, 4 September, at Marvell Hall, to welcome one of Australia’s most respected journalists.

Mullum CWA celebrates 100 years

The Mullumbimby Country Women’s Association has played a pivotal role in the local community for the last 100 years.

Rail and community consultation

The first stage of the Casino to Murwillumbah railway was opened in 1894 and shortly after the line was...

Troubled Hastings Point sewage plant upgrade goes back to the community

A long-running battle over the future of the Hastings Point Wastewater Treatment Plant has entered another round, with Tweed Council putting its preferred upgrade option back before the community.

Monster rich

For a while we visited Northern Rivers until one year we felt and saw the changes. The rich elsewhere...

Artist attempts the impossible at Lismore gallery

How do you grab hold of a horizon? Artist Lottie Consalvo has decided to have a crack.

Photo supplied

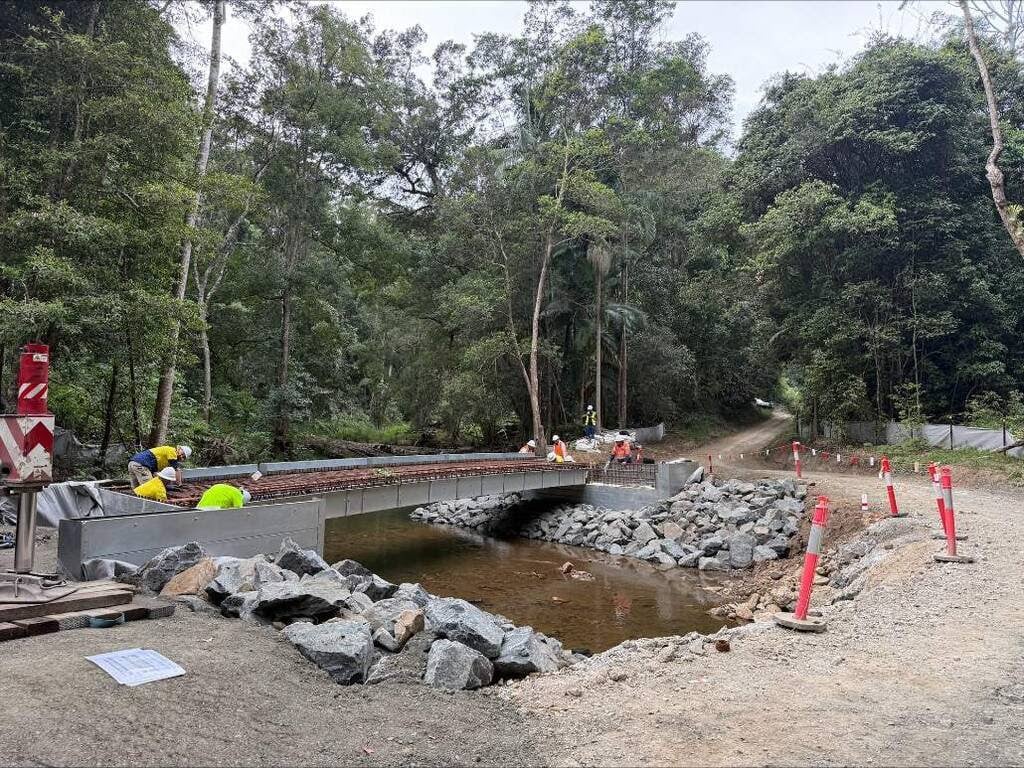

An innovative bridge is being installed at Rowlands Creek, in the Tweed Shire hinterland.

Tweed Shire Council said in a media release that it is the longest of its type for the Tweed Shire – ‘a flat-pack design that cuts construction time in half and keeps jobs local’.

‘Helping to protect threatened species near a National Park boundary, the bridge is engineered to withstand the kind of floodwaters that destroyed the previous culvert crossing.

‘The 13.7 metre bridge arrives on-site ready to assemble. The abutments go in first, anchored deep into the bedrock on each bank. Once they’re secure, the steel spans are lifted into place by crane. After that, the concrete truck rolls in to pour the deck and the structure is completed. Work started in February and completion is due in June, weather permitting.

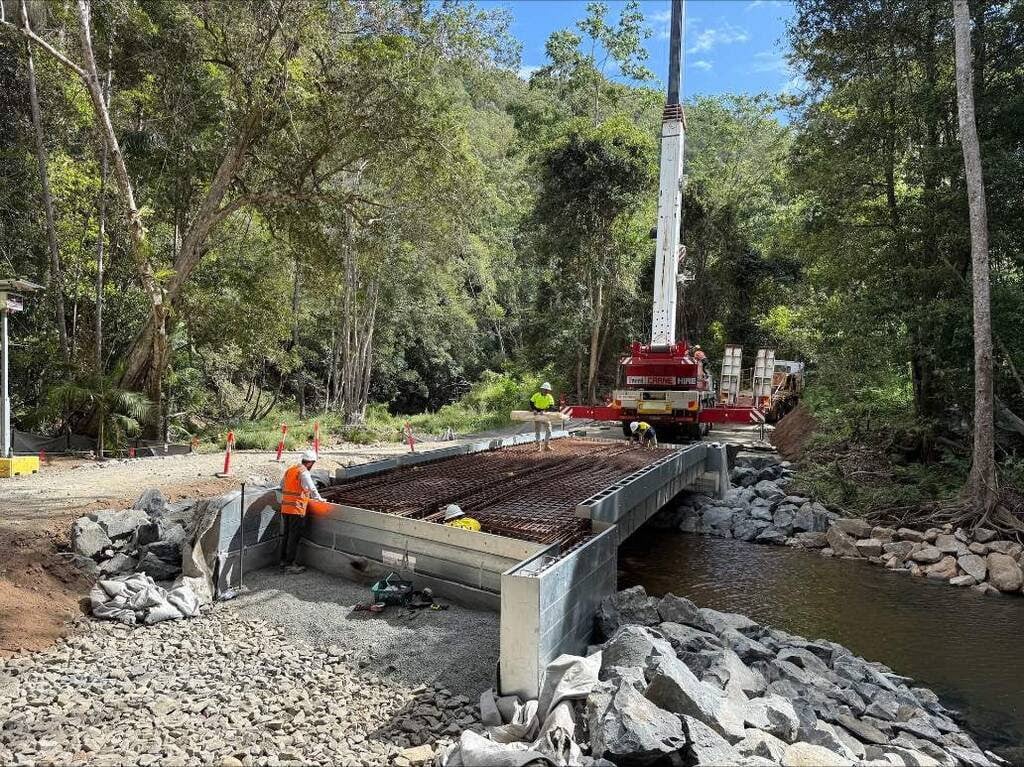

Photo supplied

‘At a remote site like Rowlands Creek, constructing a bridge would normally take several months. Using a prefabricated flat‑pack design has cut the overall construction time in half, with the bridge span itself completed in just two weeks.

‘Precision fabrication takes place in a controlled yard rather than on a remote creek bank, meaning the structure arrives on site ready to install, without sacrificing quality. The remaining construction time is focused on essential site works such as foundations, bank protection and approach works needed to support the bridge and prepare it for future floods.

‘Mullumbimby-based Ireland Civil is doing the installation as part of a $2.1 million contract, covering three bridge replacements across the Shire. Because the complex fabrication is handled off-site by Inquik Bridging Systems, local crews can take on the build without specialist equipment. The knowledge stays in the prefab yard. The construction jobs stay in the Tweed.

Photo supplied

‘Roads and bridges, people drive past them every day and don’t give them a second thought,’ said Kurt Heidecker, Tweed Shire Council’s Project Director of Flood Restoration.

‘But when you get into the detail of how they work, every one of these projects has something in it. This one has prefabrication that changes what’s possible in remote locations, is engineered to withstand floods that can strip a landscape bare, while not affecting native species. There’s more going on here than most people realise,’ he said.

Tweed Council say, ‘The Rowlands Creek site borders a national park, adding an extra layer of environmental responsibility to the project. The bridge has been designed and built to protect the Giant Barred Frog and the Southern Purple Spotted Gudgeon fish, vulnerable and threatened species found at this crossing.

‘The previous flow through culvert pipes created a narrow, fast channel that small fish and amphibians couldn’t swim against. This new open bridge span preserves natural water flow, allowing species to move freely through the waterway.

‘The bridge is replacing a structure that didn’t survive the floods, and the site tells the story. Cleanup workers arriving on site after the 2022 flood described a landscape stripped of all vegetation by floodwaters that were unbelievably deep, fast and high velocity.

‘This new bridge is designed for that. The abutments are drilled into rock. Massive boulders line the banks for scour protection. And when floodwater rises, the bridge goes under with it —protected by galvanised steel formwork that absorbs and spreads the impact when debris strikes, rather than damaging the concrete bridge abutments.

‘It’s a really neat solution,’ Mr Heidecker said.

‘The fish can travel as they need to. The structure is built to handle what this creek throws at it. And we’ve got a local company doing the work.’

More information – tweed.nsw.gov.au/flood-restoration-works
